DavSam Bridge Project Faces Funding Crisis, Completion Potentially Delayed to 2030
DavSam Bridge Funding Crisis May Delay Completion to 2030

DavSam Bridge Project Confronts Funding Shortfall, Risking Delays Until 2030

The Regional Project Monitoring Committee–Davao Region (RPMC-Davao) has issued a stark warning regarding the Samal Island-Davao City Connector (SIDC) Bridge Project, widely known as the DavSam Bridge. According to the committee, the landmark infrastructure initiative is grappling with significant funding constraints that could force a suspension of construction activities by May 30, 2026, and potentially push the final completion date to September 2030.

Monitoring Reveals Critical Financial Gaps

During its second-quarter field monitoring activity conducted on April 7-8, 2026, the RPMC-Davao assessed major infrastructure projects across Davao City and Davao del Norte. The committee's findings highlighted that the SIDC Bridge is experiencing funding issues alongside delays in right-of-way (ROW) acquisitions. These challenges pose substantial risks to the timely realization of the project and could undermine its anticipated economic and social benefits for the region.

"Funding gaps and ROW delays affecting both projects pose significant risks to timely completion and may undermine their intended economic and social benefits," the RPMC stated in its report.

Wide Pickt banner — collaborative shopping lists app for Telegram, phone mockup with grocery list

Progress Amidst Uncertainty

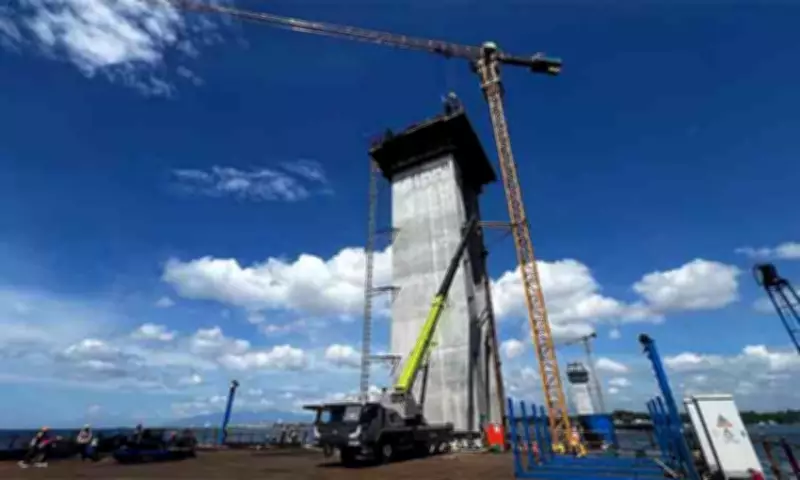

Despite the looming financial hurdles, the project has demonstrated notable progress. As of March 25, 2026, the SIDC Bridge has achieved a physical accomplishment rate of 55.97 percent, surpassing its target of 52.96 percent. Key milestones include the completion of all bored-pile works, ongoing construction of pier columns and pile caps on both sides, and continued advancement on the navigation bridge structures and marine viaducts.

However, this progress is threatened by a pressing need for approximately ₱4.69 billion in funding for the year 2026. The Department of Public Works and Highways (DPWH) had previously adjusted the completion timeline from August 30, 2027, to September 2028, with the potential for a further extension to September 2030 due to these financial constraints.

Project Specifications and Impact

The SIDC Bridge is designed as a toll-free, four-lane extradosed bridge spanning 4.76 kilometers. It will connect R. Castillo–Daang Maharlika in Davao City to the Samal Circumferential Road. Engineering features include a 275-meter main span, a 47-meter vertical clearance to accommodate marine traffic, and a 1.62-kilometer marine section supported by 73-meter-high pylons. The project also incorporates roundabouts, ramps, and approach roads to ensure seamless integration with existing transport networks.

Upon completion, the bridge is expected to drastically reduce travel time between Davao City and the Island Garden City of Samal from 30-50 minutes to approximately five minutes. This improvement is projected to significantly boost regional trade, enhance tourism opportunities, and foster greater connectivity within the Davao Region.

Legal Challenges and Resolutions

The project has not been without its legal obstacles. On July 1, the Supreme Court issued a Writ of Kalikasan, directing the DPWH, the Department of Environment and Natural Resources (DENR), the Samal Island Protected Landscape and Seascape Protected Area Management Board, and China Road and Bridge Corp. to respond within ten days from the order's issuance. The Court also referred a request for a Temporary Environmental Protection Order (TEPO) to the Court of Appeals in Cagayan de Oro.

However, on June 10, 2025, the Court of Appeals denied the petition to halt construction, allowing the project to proceed despite environmental concerns. This legal resolution provided a temporary reprieve, but the current funding crisis now presents a more immediate threat to the bridge's timeline.

The RPMC-Davao's monitoring underscores the delicate balance between infrastructure ambition and fiscal reality. As stakeholders await further developments, the future of the DavSam Bridge hangs in the balance, with its potential to transform regional mobility contingent on resolving these critical funding issues.
